People’s Street Boardwalk

People’s Street Boardwalk

For more than three decades, Peoples Street Boardwalk connected residents, visitors, and marina tenants with Corpus Christi Bay. Built in 1989, its timber walkway and 13 finger piers formed part of the downtown waterfront experience: a place to walk beside the water, reach a boat slip, and visit nearby businesses.

Hurricane Hanna badly damaged the boardwalk in 2020. Decking was removed for safety, and local reporting documented storm damage still evident in 2022. The interruption lasted well beyond the storm itself. A familiar public amenity had become damaged infrastructure awaiting a lasting replacement.

SR Trident’s reconstruction incorporated approximately 184 prestressed concrete piles, 275 cubic yards of precast pile caps, and 13,036 square feet of precast concrete deck panels. These structural elements supported the replacement boardwalk and finger piers.

The work also included approximately 12,985 square feet of composite decking, 960 linear feet of rubber fendering, 489 linear feet of guard railing, and 36 composite guide piles, together with upgraded utilities and waterfront furnishings.

These quantities represent substantial marine construction within a restricted footprint beside operating businesses and occupied marina facilities. SRT had to coordinate equipment, materials, and installation while respecting the activity around the work.

Scheduling and public access

Weather and restricted space made the schedule dependent on workable marine conditions and equipment access. Material staging, barge positioning, and installation sequencing had to be considered together rather than planned as separate activities.

SRT coordinated with the City’s Parks and Recreation Department to maintain at least one lane of traffic. The team limited the duration of work near businesses to return affected areas to operation as quickly as possible.

This approach connected construction sequencing with business continuity. Marine work had to progress within the available footprint while roadway access continued beside it. The project occupied one site; its coordination challenge was the concentration of construction and public activity within that site.

A waterfront returned to use

SR Trident self-performed approximately 86% of project labor. The project recorded 33,059 man-hours without a recordable injury across the marine reconstruction.

Electrical improvements included approximately 12 dock pedestals, two 150-kVA marine substations, and one 800-amp, 480-volt distribution panel, alongside wiring and potable water service.

The completed waterfront also incorporated approximately 12 benches, six trash receptacles, and 116 pile-top cone covers. These supporting components brought utilities, finishes, and public amenities into the completed structure.

What the community receives back

Residents and visitors receive a renewed place to walk beside the bay and enjoy the waterfront. Marina tenants regain finger-pier access and supporting utilities. Nearby businesses again have a restored public amenity within their waterfront setting.

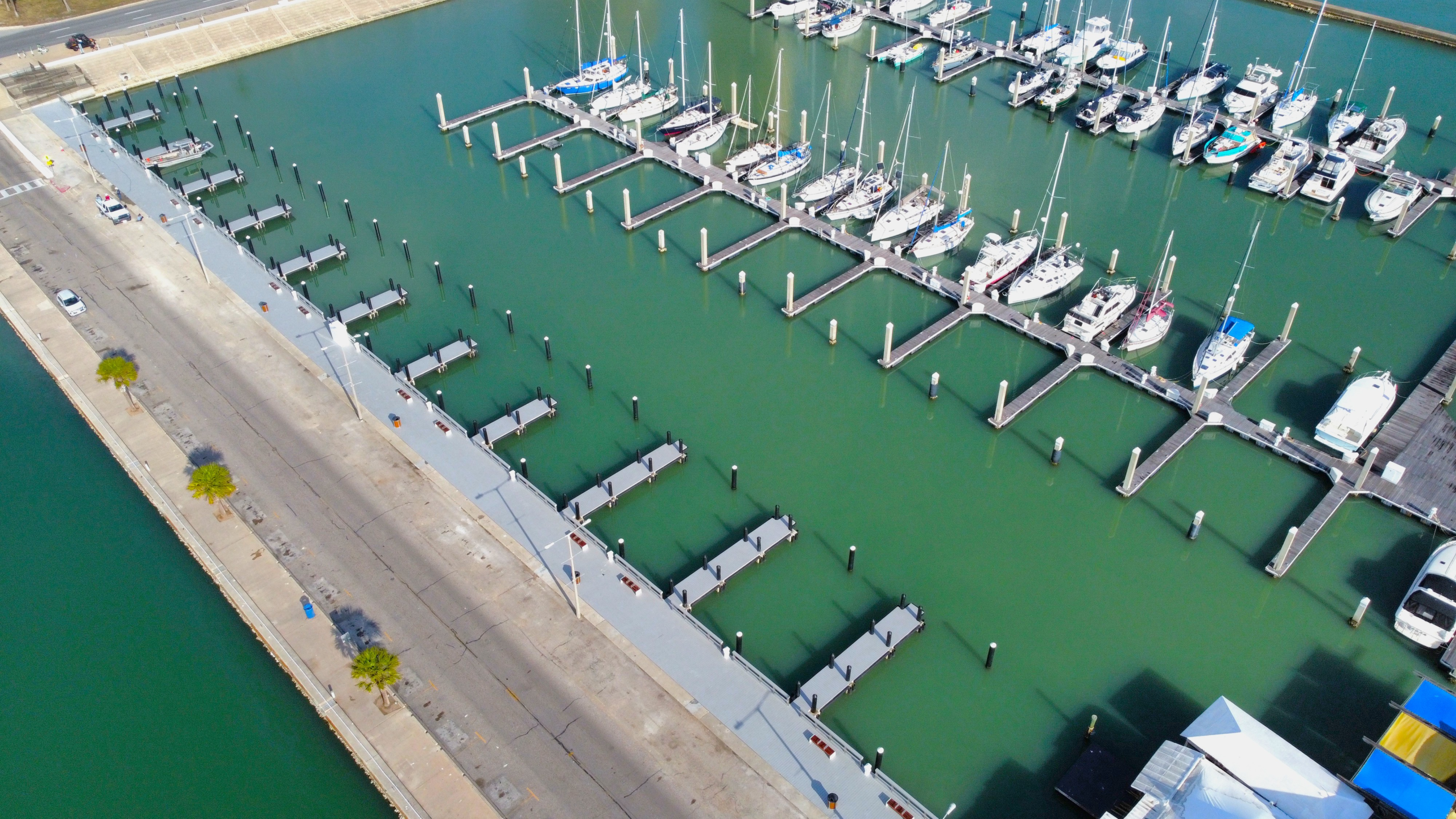

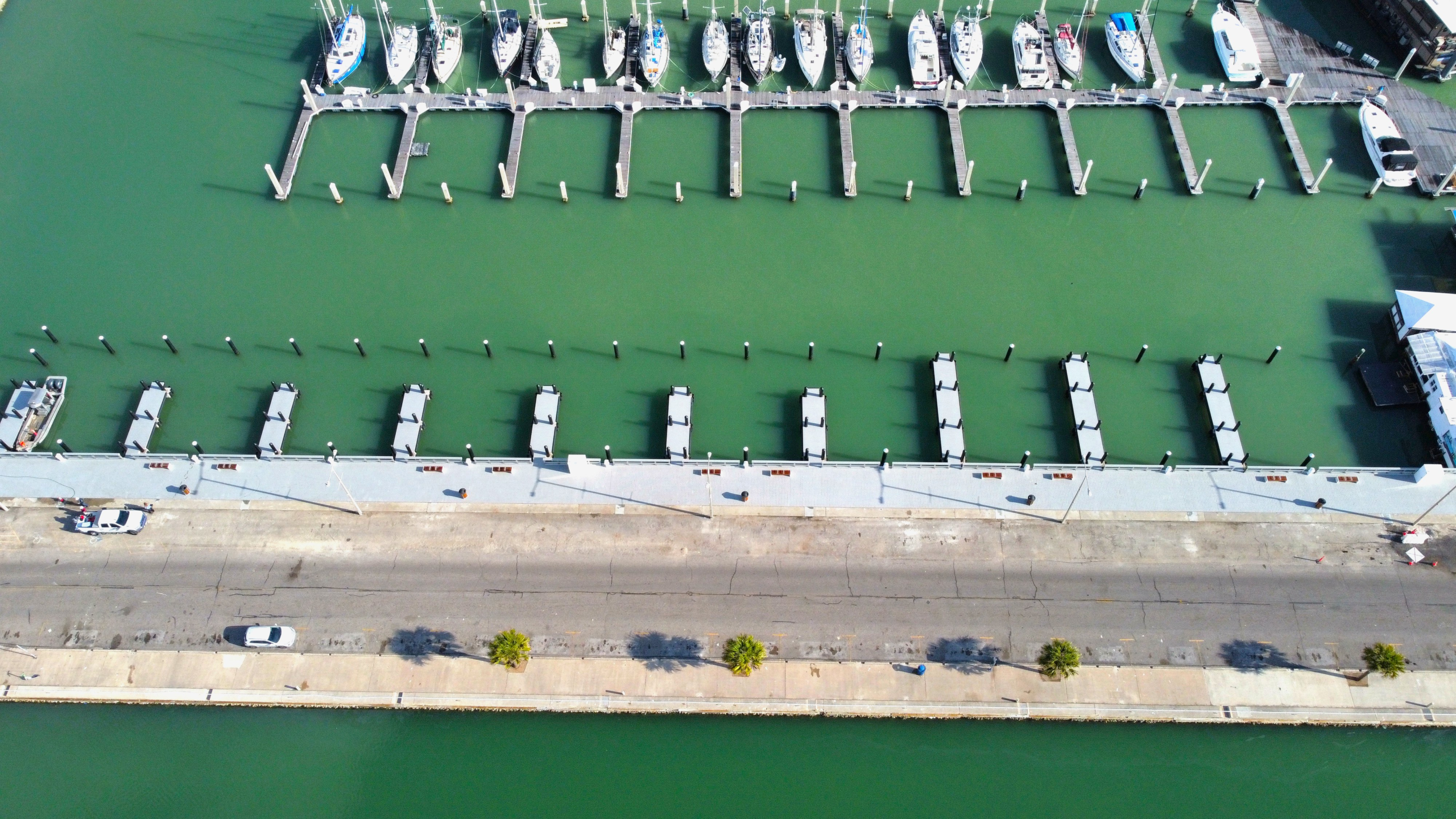

After years of storm damage and safety concerns, the replacement returns a familiar connection to Corpus Christi Bay with renewed infrastructure and finished public space.



Contact SR Trident today to partner with Texas' leading industrial construction contractor.
Seraphinite AcceleratorOptimized by Seraphinite Accelerator
Turns on site high speed to be attractive for people and search engines.
